Ford Transit Build Guide

All 19 phases of a Transit conversion, in the order we build them in our Loveland shop, with the parts each phase calls for.

The build sequence

From empty shell to finished rig.

Every Ford Transit conversion runs the same order of operations. Get the sequence wrong and you insulate before you cut windows, or run wire after the walls go up. This is the order we build them in our Loveland shop, with the parts each phase calls for.

19
Phases
9–14
Weeks, typical DIY
148/148 EXT
Medium/High Roof
11
Phases before the walls
  1. 1Pick your van
  2. 2Follow the phases in order
  3. 3Add parts as you go
Your Transit
Parts below filter to the van you pick.
01

Order Your Van

Weeks to monthsBefore anythingDifficulty

The build starts at the order sheet. Wheelbase, roof height and a handful of factory options decide what you can build later, and most of them can't be added after the van leaves the factory. Spend the time here — it's the cheapest phase to change your mind in.

360° view: Order Your Van
Order Your Van video
Get this right

Order the van for the build, not for the lot. Factory windows land where they land, and a window where your galley should go means redesigning around it or cutting it out. Spec the glass, the electrical prep and the seating up front — and if you can't wait for an order, check the window sticker against your floor plan before you sign.

02

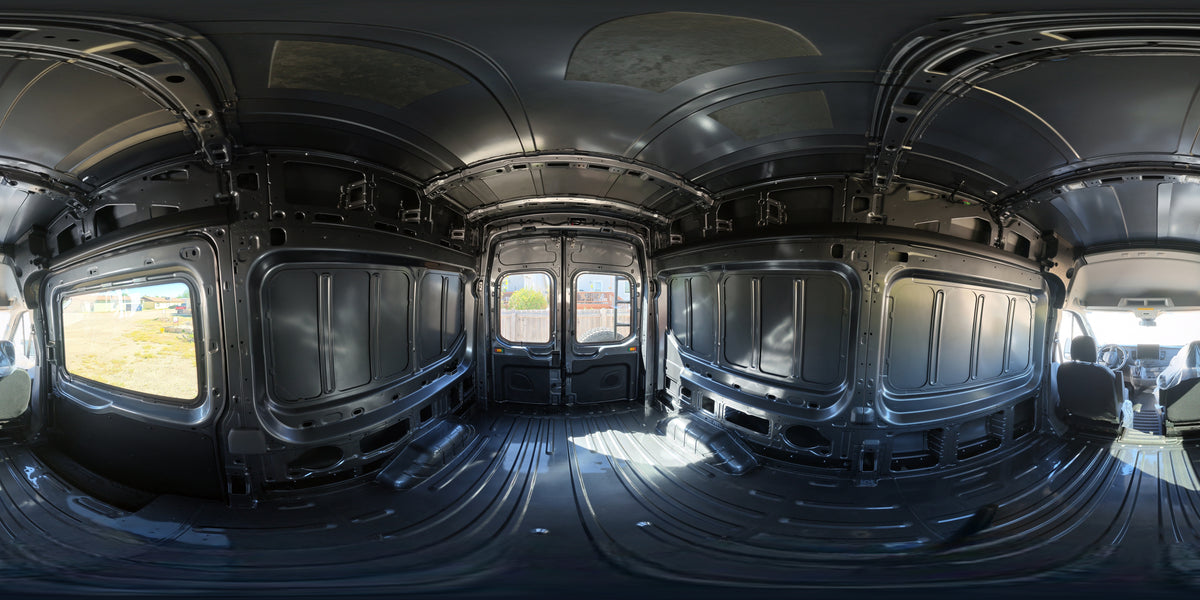

Plan & Measure

1–2 weeksBefore anythingDifficulty

Nothing gets cut until the layout is settled on paper. Tape the floor plan out full size, sit in it, and move things until the walkway and the bed both work. Every hour here saves a day later.

360° view: Plan & Measure
Plan & Measure video
Get this right

Weight and axle load are the two numbers people skip. A high-roof 148 has real payload limits, and water plus batteries plus gear eats them fast. Budget mass by phase, not at the end.

Parts for this phase 3
  • Option $225.00
  • Option $180.00
  • Option $89.00
03

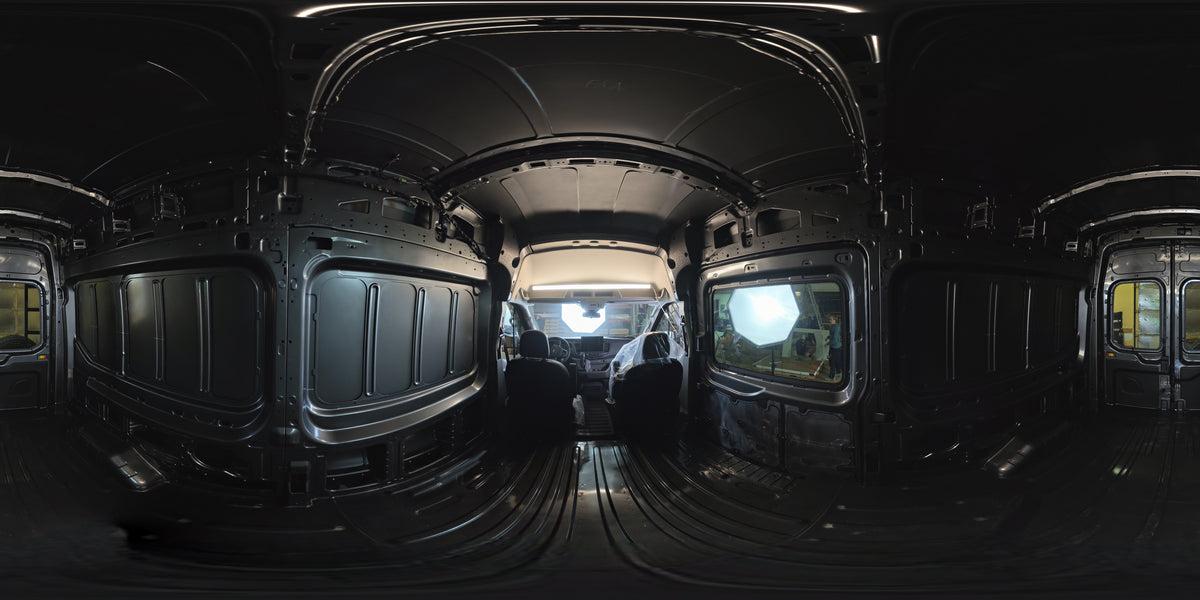

Strip & Prep

1–2 daysBefore insulationDifficulty

Factory liner, cargo flooring, and the plastic trim all come out. You want bare metal, clean and dry, with every threaded hole in the body mapped — those captive nuts are free mounting points later.

360° view: Strip & Prep
Strip & Prep video
Placeholder clip — swap for the strip-and-prep video.
Get this right

Don't bin the factory hardware. The bolts holding the cargo floor and the D-ring anchors are the correct thread pitch for reuse, and Ford charges real money to replace them.

Parts for this phase 1
04

Cut Openings

1–3 daysBefore insulationDifficulty

Windows, roof fan, and any wall or floor penetrations get cut while the shell is empty and you can reach both sides of the metal. This is the phase people put off, and putting it off is what forces them to tear insulation back out.

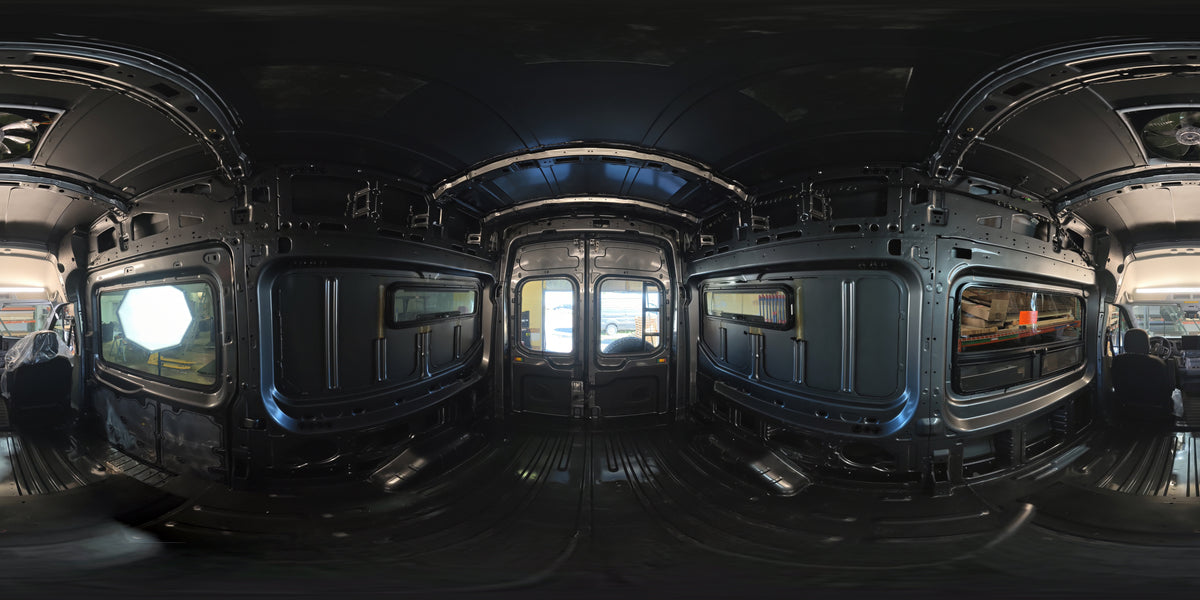

360° view: Cut Openings
Cut Openings video
Get this right

Cut once. Measure from a body seam, not from a panel edge — Transit panel edges are not square to the world. Deburr and prime every cut edge before the glass or flange goes in, or you'll be chasing rust in two winters.

Parts for this phase 3
05

Fan and Air Conditioning

1–2 daysAfter openings, before insulationDifficulty

The roof fan and any rooftop or split A/C go in while the roof is still bare and you can reach both sides of the metal. Air is what makes a van livable — a fan moves moisture out every night of the year, and A/C is what lets you sleep in it in July.

360° view: Fan and Air Conditioning
Fan and Air Conditioning video
Get this right

Never cut a roof bow. The fan and A/C openings go between the ribs, and the flange gets butyl tape plus a self-levelling lap sealant — not silicone. Silicone cracks and lets water in, and you won't find the leak until it has soaked your insulation.

06

Sound Deadening

4–8 hoursBefore insulationDifficulty

Constrained-layer damping on the large flat panels kills the drum effect. You are not trying to cover the van — roughly a quarter to a third coverage on the big unsupported areas does almost all the work.

360° view: Sound Deadening

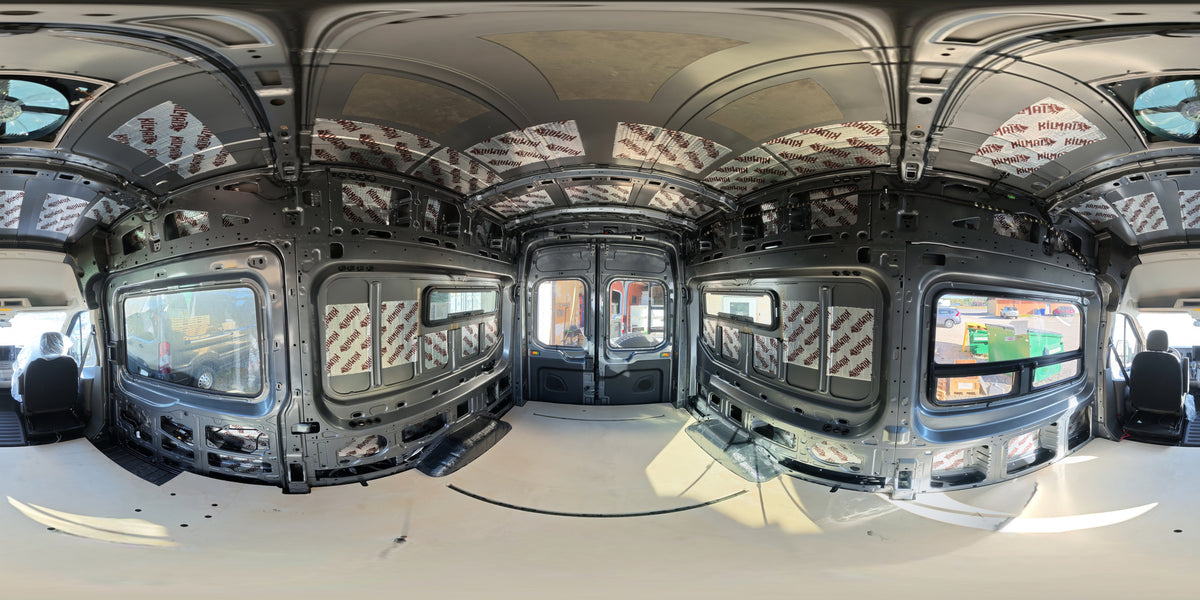

Sound Deadening video
Get this right

Full coverage is wasted weight and money. Tap each panel with a knuckle and treat the ones that ring, not the ones that thud.

Parts for this phase 1
07

Subfloor & Flooring

1–2 daysBefore wallsDifficulty

The floor goes in as one job: insulated subfloor, then the finish floor on top, then step and trim to close the edges. The subfloor is the datum for everything above it — cabinet heights, bed height, step height, and where the wall panels land all reference this plane. Our systems are cut to the Transit floor pan, so you're not scribing plywood to a corrugated deck.

360° view: Subfloor & Flooring
Subfloor & Flooring video
Get this right

Get it flat and level side to side before anything goes on top. A subfloor that rocks telegraphs into every cabinet door you hang for the rest of the build. Once the finish floor is down, cover it — you still have walls, trim and cabinetry to build on top of it.

Parts for this phase 9
  • Core Insulated — no separate floor insulation needed.$2,375.00
  • Core Insulated — no separate floor insulation needed.$2,475.00
  • Core $700.00
  • Core $1,050.00
  • Core $1,300.00
  • Core $1,600.00
  • Core $1,150.00
  • Option $175.00
  • Option $215.00
08

Insulation

2–4 daysAfter openingsDifficulty

Walls, ceiling, and cavities get filled. In a metal box that swings 60°F in a day, the goal is continuous coverage with as few thermal bridges as you can manage — and no trapped moisture.

360° view: Insulation

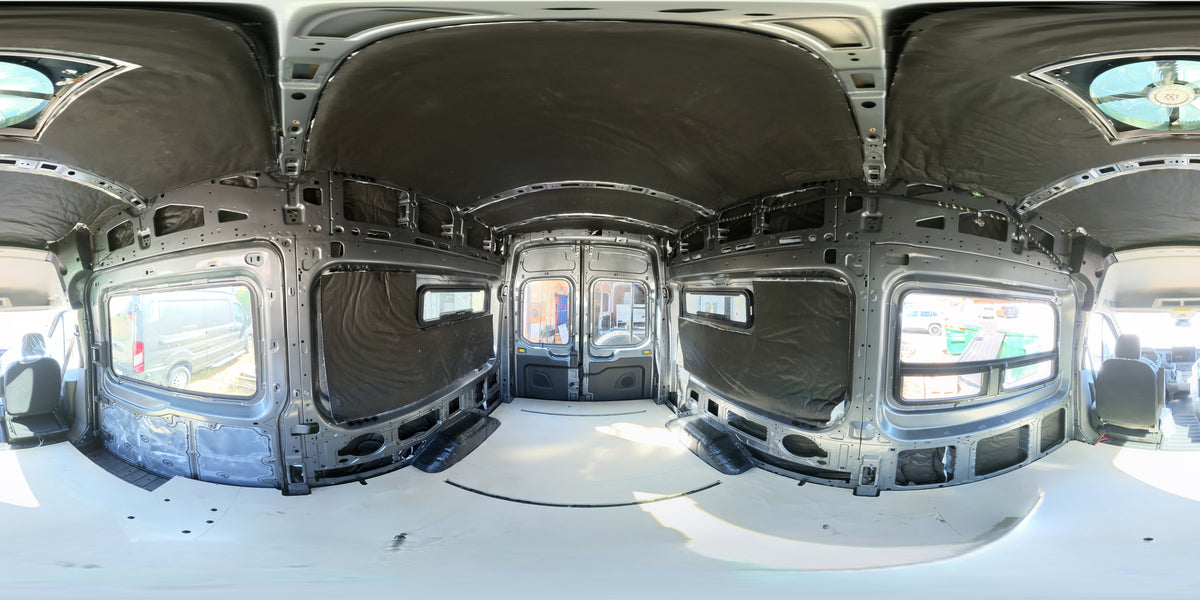

Insulation video
Get this right

Do not stuff insulation into the lower door cavities or any channel with a factory drain. Those drains exist because water gets in. Block them and you build a rust incubator.

Parts for this phase 2
09

Electrical Rough-In

3–6 daysWith insulation, before wallsDifficulty

Every wire that will ever live behind a wall goes in now: battery, inverter, solar, 12V runs, the charge line from the alternator, and every switch leg. Running it while the insulation is still open means you can see every cavity you are feeding, and floor-level runs can drop before the subfloor covers them.

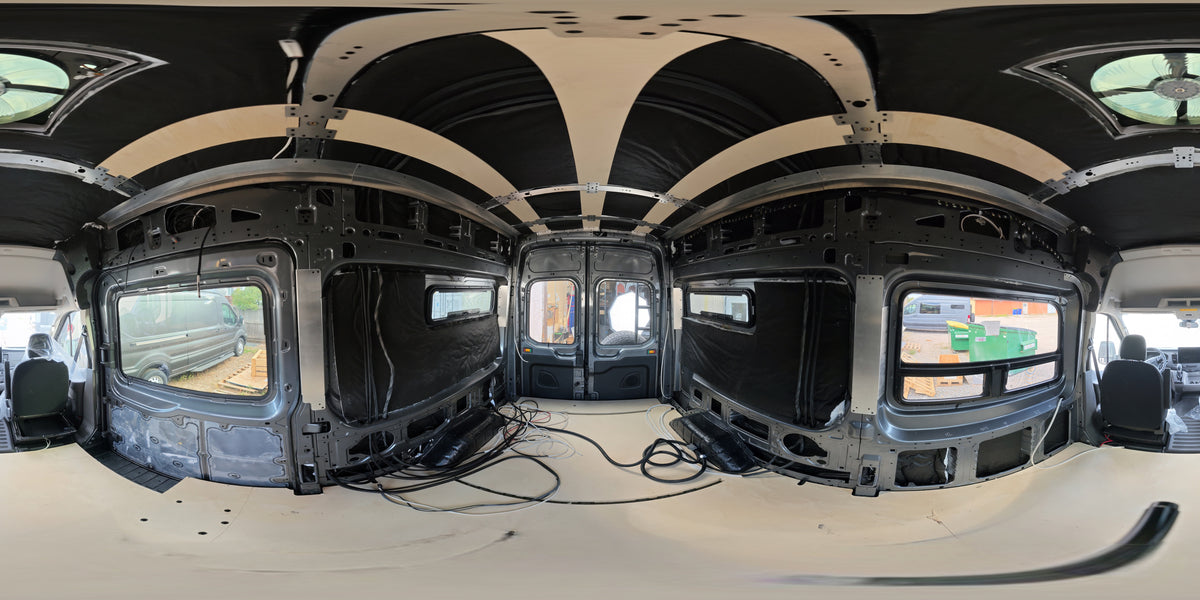

360° view: Electrical Rough-In
Electrical Rough-In video
Get this right

Pull more than you think you need and leave service loops. Adding one circuit after the wall panels are upholstered means taking a wall back off, and the panel never sits quite the same twice.

Parts for this phase 2
10

Furring & Framing

1–2 daysBefore wallsDifficulty

Furring gives the wall and ceiling panels something to land on, at a consistent depth, without you fabricating brackets. Aluminum keeps the weight down and won't rot if condensation ever finds it.

360° view: Furring & Framing
Furring & Framing video
Get this right

Every furring run is also a future mounting point. Photograph the layout with a tape in frame before the panels cover it — you will want to know where to drive a screw for a shelf six months from now.

Parts for this phase 5
  • Core $225.00
  • Core $362.00
  • Core $843.00
  • Core $100.00
  • Option $197.00
11

Trim & Upholstery

1–2 daysBefore wallsDifficulty

The front compound curve and the styrofoam blobs at the B pillars are the hardest shapes in the van to finish by hand. Setting the trim before the panels gives the wall and ceiling kits a finished edge to land against, instead of you scribing panels to a curve.

360° view: Trim & Upholstery
Placeholder panorama (panels and floor in) — replace with the shot from this phase.
Trim & Upholstery video
Get this right

Dry-fit the trim and the wall panels together before you fasten anything down. The trim sets the reveal the panels butt into, so a piece sitting proud pushes every panel behind it out of line.

Parts for this phase 7
  • Core $1,250.00
  • Core $800.00
  • Core $890.00
  • Option $500.00
  • Option $390.00
  • Option $425.00
  • Option $390.00
12

Walls & Ceiling

1–3 daysAfter all rough-inDifficulty

The moment it stops looking like a cargo van. Our kits are CNC cut to the Transit shell, so the panels drop onto the furring you already set instead of you scribing plywood to a curve for a week.

360° view: Walls & Ceiling
Placeholder panorama (panels and floor in) — replace with the shot from this phase.
Walls & Ceiling video
Get this right

Dry-fit the whole kit before you upholster or fasten anything permanently. Confirm every rough-in is where you think it is, and that your window openings line up with the panel cutouts.

Parts for this phase 15
  • Core $2,700.00
  • Core $3,745.00
  • Core $2,550.00
  • Core $3,545.00
  • Core $2,950.00
  • Core $4,445.00
  • Option $2,000.00
  • Option $800.00
  • Option $25.00
  • Option $13.50
  • Option $299.95
  • Option $2,700.00
  • Option $3,745.00
  • Option $2,950.00
  • Option $4,445.00
13

Take a Rest Phase

As long as you needHalfway, before cabinetryDifficulty

Walls are up, the rough-in is done, and nothing is permanent yet. This is the best moment in the whole build to stop and use the van — throw a mattress on the floor, go somewhere for a weekend, and live with the empty shell before you commit to cabinets.

360° view: Take a Rest Phase
Take a Rest Phase video
Get this right

Pay attention to how you actually use the space. Where you reach for a light, where you sit to put shoes on, where the condensation shows up in the morning. Every one of those notes is free now and a rebuild later.

Parts for this phase 5
  • Option $26.00
  • Option $23.00
  • Option $26.11
  • Option $23.00
  • Option $23.00
14

Cabinetry & Build-Out

2–4 weeksAfter wallsDifficulty

The longest phase by a wide margin. Unistrut gives you a structural rail to hang cabinets from without hunting for studs that don't exist, and the aluminum cabinet line bolts to it.

360° view: Cabinetry & Build-Out
Placeholder panorama (panels and floor in) — replace with the shot from this phase.
Cabinetry & Build-Out video
Get this right

Mount to structure, never to wall panel. A cabinet full of tinned food that pulls off an upholstered panel at highway speed is the single most dangerous thing in an amateur build.

Parts for this phase 11
  • Core $100.00
  • Core $25.00
  • Option $1,650.00
  • Option $1,500.00
  • Option $2,775.00
  • Option $1,600.00
  • Option $2,687.00
  • Option $2,645.00
  • Option $450.00
  • Option $49.00
  • Option $350.00
15

Power System

2–4 daysAfter cabinetryDifficulty

The wiring went in during rough-in. Now the system it feeds goes in — battery, inverter, charger, alternator charging and solar — mounted in the cabinet you built for it. Commission it one circuit at a time so a fault shows up on the circuit that caused it.

360° view: Power System
Power System video
Get this right

Fuse every positive as close to its source as you can, and size cable for both current and run length — an undersized cable is a heater. Lithium batteries can't charge below freezing unless they're heated, so mount them inside the insulated envelope, not under the van.

Parts for this phase 3
  • Core $8,246.00
  • Core $7,239.00
  • Option $2,645.00
16

Plumbing Rough-In

2–4 daysAfter cabinetryDifficulty

Tanks, pump and the runs that feed the galley go in once the cabinets are set, so every fitting lands where the fixtures actually ended up rather than where the drawing said they would. Undercarriage and wheel-well tanks mount from below, so they stay reachable throughout.

360° view: Plumbing Rough-In
Placeholder panorama (insulated and framed) — replace with the shot from this phase.
Plumbing Rough-In video
Get this right

Pressure-test the whole system and leave it under pressure overnight before you close any cabinet face over a fitting. A weeping joint you can reach is a ten-minute fix; the same joint behind a finished cabinet is a weekend.

17

Heating

1–2 daysBefore wallsDifficulty

A gasoline heater tapping the main tank is the setup we install most. The fuel pickup, exhaust routing, and combustion air all have to be done properly, and all of it wants to happen before the interior closes up.

360° view: Heating
Placeholder panorama (insulated and framed) — replace with the shot from this phase.
Heating video
Get this right

Exhaust routing is a safety item, not a fitment item. It must exit clear of any opening, be supported so it cannot contact anything combustible, and never be shortened below the manufacturer's minimum length.

Parts for this phase 2
  • Core $1,819.01
  • Core $175.00
18

Finishing

2–5 daysLastDifficulty

Door storage, window covers, the privacy curtain and bug screens. None of it is structural — all of it is what you notice every single day you use the van.

360° view: Finishing
Placeholder panorama (panels and floor in) — replace with the shot from this phase.
Finishing video
Get this right

Cut the window covers to the actual openings, not just the pattern, and label each one to its window as you go. They all look the same at six in the morning in a dark parking lot.

Parts for this phase 5
19

Exterior

1–3 daysLastDifficulty

Roof rack, ladder, side steps, awning and lighting. The exterior is what lets you carry gear and get to it — and it goes on last so nothing gets scratched while you're still working inside.

360° view: Exterior
Exterior video
Get this right

Everything on the roof changes your clearance height and adds weight up high. Measure the finished van, put the number where the driver sees it, and torque-check every exterior fastener after the first few hundred miles.

Parts for this phase 1
